1.6 An overview of DMO's business is presented in the following figures and tables.

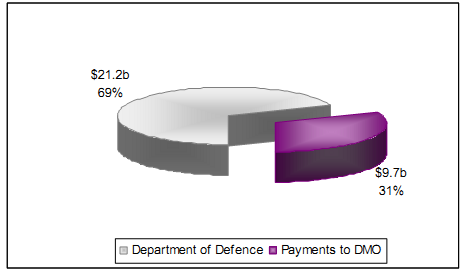

1.7 The total budget for the Department of Defence in 2010-11 was $30.9b. Of this, $9.7b152 was budgeted for planned payments to the DMO under Purchaser Provider Arrangements to support the DMO's acquisition and sustainment activities. Figure 1.1 demonstrates the significant investment made in DMO to support capability for the ADF, and when assessing the DMO budget as a whole ($10.4b in 2010-11 including service fee153), equates to 0.8% of Australia's Gross Domestic Product (GDP) in 2010-11.
Figure 1.1 - Payments to DMO as a Proportion of the Department of Defence Budget 2010-11

1.8 A Capability, defined as 'the power to achieve a desired operational effect in a nominated environment, within a specified time, and to sustain that effect for a designated period'154, is generated by a number of Fundamental Inputs to Capability (FIC) namely:
• organisation;
• personnel;
• collective training;
• materiel systems;
• supplies;
• facilities;
• support;
• command; and
• management.
1.9 The DMO is primarily responsible for managing the procurement and ongoing sustainment of the materiel systems component of capability, comprising mission systems, designated elements of training and non- infrastructure equipment for facilities that support the operation of ADF equipment, such as simulators, trainers and unique test equipment. Defence has overarching responsibility to deliver all inputs to capability.
1.10 Capability systems have a life cycle that begins with the identification of a need, moving through to identifying the requirements, then to the acquisition of the capability, operating and sustaining it in-service, and then the final disposal phase once the equipment is no longer required.
1.11 As figure 1.2 demonstrates, the 2010-11 budget allocation between acquisition and sustainment is relatively evenly distributed. This demonstrates the strategic significance of sustainment activities and the ongoing effort required to maintain the necessary level of operational capability. The size of the sustainment budget also reflects the technically challenging nature of sustainment activities. The budget for provision of management services and policy advice is relatively small (representing approximately 9% of the DMO's total budget), to maintain the essential DMO corporate management and governance functions that support the acquisition project and sustainment product functions.

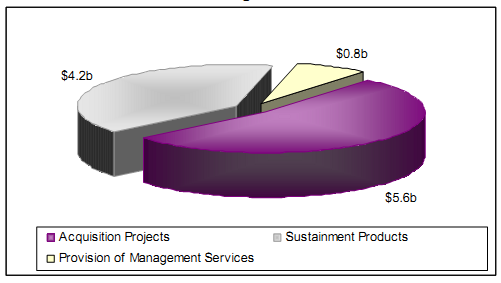

Figure 1.2 - DMO Budget Allocation to Acquisition Projects, Sustainment Products and Management Services 2010-11

1.12 As Figure 1.3 demonstrates, the DMO expended 102% ($10.6b) of its budget allocation against the 2010-11 Portfolio Additional Estimates Statements ($10.4b), which reflects the strong capital performance by DMO projects and the acceleration of some program activity.
Figure 1.3 - DMO Expenditure Allocation to Acquisition Projects, Sustainment Products and Management Services 2010-11

1.13 Approximately two thirds of acquisition projects undertaken in the DMO are considered 'Major Projects' with the remainder classified as 'Minor Projects' (see figure 1.4 below). Major capital acquisition projects are funded through the Defence Capability Plan (DCP) and generally have a budget allocation of more than $20m. Projects of lesser value may also be funded through the DCP if they are particularly complex or of strategic significance.

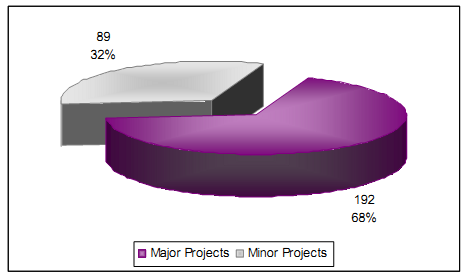

Figure 1.4 - Number of Major and Minor Acquisition Projects 2010-11

1.14 A Minor Capital Acquisition Project is funded through a Defence Group budget allocation under the Minor Capital Acquisition Program (generally by a Service Group - Navy, Army, or Air Force). Minor projects, although generally costing less than $20m, are not necessarily of low significance from a capability perspective as they can either include essential equipment to sustain and protect our troops or have crucial interdependency with major capability.
1.15 The 28 major DMO projects covered by this MPR are shown in table 1.1.
Table 1.1 - List of 2010-11 MPR Projects by Total Approved 155
Project Name | Project Number | 2010-11 In-Year Budget $m156 | Total Approved Project Budget $m157 |
Air Warfare Destroyer | SEA 4000 Phase 3 | $982.5 | $7,931.8 |
Airborne Early Warning & Control Aircraft | AIR 5077 Phase 3 | $217.1 | $3,859.5 |
Multi Role Helicopter | AIR 9000 Phase 2, 4 & 6 | $326.0 | $3,753.7 |
Bridging Air Combat Capability | AIR 5349 Phase 1 & 2 | $426.4 | $3,578.5 |
Field Vehicles and Trailers | LAND 121 Phase 3 | $77.1 | $3,263.9 |
Amphibious Deployment and Sustainment | JP 2048 Phase 4A & 4B | $497.8 | $3,122.6 |
New Air Combat Capability | AIR 6000 Phase 2 | $78.3 | $2,666.8 |
Armed Reconnaissance Helicopter | AIR 87 Phase 2 | $117.3 | $2,060.3 |
F/A-18 Hornet Upgrade | AIR 5376 Phase 2 | $73.1 | $1,917.5 |
C-17 Heavy Airlifter | AIR 8000 Phase 3 | $6.7 | $1,848.9 |
Air to Air Refuelling | AIR 5402 | $326.0 | $1,828.5 |
Guided Missile Frigate Upgrade | SEA 1390 Phase 2.1 | $21.1 | $1,528.9 |
F/A-18 Hornet Structural Refurbishment | AIR 5376 Phase 3.2 | $16.9 | $951.3 |
Bushmaster Protected Mobility Vehicle | LAND 116 Phase 3 | $109.0 | $929.8 |
Next Generation SATCOM Capability | JP 2008 Phase 4 | $189.3 | $880.9 |
High Frequency Modernisation | JP 2043 Phase 3A | $19.4 | $670.8 |
SM-1 Missile Replacement | SEA 1390 Phase 4B | $27.9 | $612.0 |
Additional Chinook Helicopter | AIR 9000 Phase 5C | $6.2 | $584.6 |
Armidale Class Patrol Boat | SEA 1444 Phase 1 | $7.2 | $537.2 |
Anzac Ship Anti Ship Missile Defence | SEA 1448 Phase 2B | $73.8 | $462.0 |
Collins Replacement Combat System | SEA 1439 Phase 4A | $4.8 | $450.4 |
Replacement Heavyweight Torpedo | SEA 1429 Phase 2 | $19.2 | $425.4 |
Collins Reliability and Sustainability | SEA 1439 Phase 3 | $16.9 | $411.4 |
Indian Ocean UHF SATCOM Capability | JP 2008 Phase 5A | $110.9 | $407.2 |
Anzac Ship Anti Ship Missile Defence | SEA 1448 Phase 2A | $41.4 | $389.5 |
Follow-on Stand Off Weapon | AIR 5418 Phase 1 | $48.4 | $343.3 |
Artillery Replacement | LAND 17 Phase 1A | $64.4 | $326.1 |
Battlefield Command Support System | LAND 75 Phase 3.4 | $58.5 | $325.9 |
| Total | $3,963.7 | $46,068.7 |
