| Item | Original Planned | Achieved /Forecast | Variance (Months) | Variance Explanation / Implications |
| Initial Materiel Release (IMR) | Dec 14 | Dec 15 | 12 | Delays with initial block production. This has a flow on effect to later milestones. |
| Jun 16 | Jun 17 | 12 |
| |
| Final Materiel Release (FMR) | Dec 17 | Dec 18 | 12 |
|
| Dec 18 | Dec 19 | 12 |
|

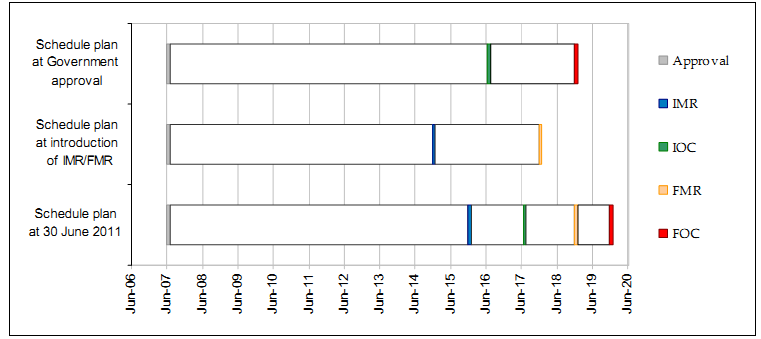

Schedule Status as at 30 Jun 11
