6.1 Project Maturity Score and Benchmark

Maturity Score

Attributes

Total

Schedule

Cost

Requirement

Technical Understanding

Technical
Difficulty

Commercial

Operations and Support

Project Stage

Benchmark

8

7

8

8

8

8

8

55

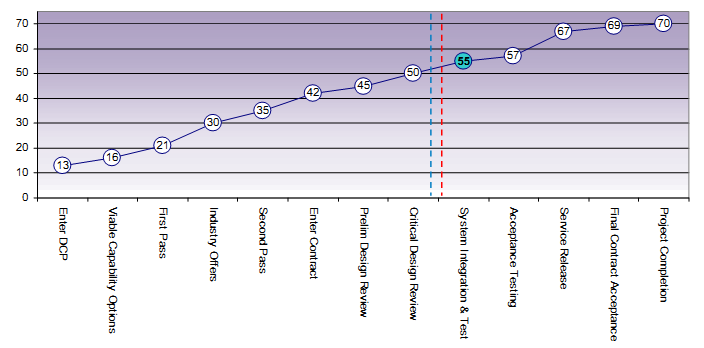

System Integration and Test

Project Status

7

7

8

8

8

6

9

53



•  Schedule: Delays associated with sub-system integration; mission computing, loading and latency, radar and electronic support measures maturity and stability; and supplier hardware availability

•  Commercial: The Commonwealth assesses that there is some continuing risk to Boeing's delivery plans.

•  Operations and Support: Operations and support systems have begun transitioning to the operational environment with Initial Acceptance of the first four aircraft.

2009-10 DMO MPR Status- - - -

2010-11 DMO MPR Status- - - -
