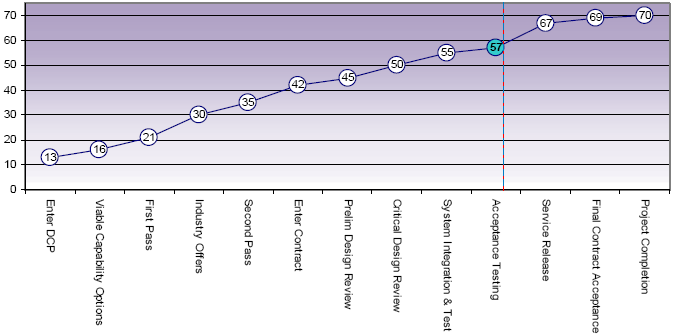

Maturity Score | Attributes | Total | ||||||||
Schedule | Cost | Requirement | Technical Understanding | Technical Difficulty | Commercial | Operation and Support | ||||
Project Stage | Benchmark | 8 | 8 | 8 | 8 | 9 | 8 | 8 | 57 | |
Acceptance Testing | Project Status | 9 | 8 | 9 | 8 | 9 | 6 | 9 | 58 | |
Explanation | • Schedule: In Service Date achieved in December 2004 with remainder of schedule well understood. • Requirement: Integration and testing has verified achievement of the majority of the endorsed requirements. Operational Test and Evaluation has validated delivery of a deployable troop capability through the granting of Operational Capability 1 by the Chief of Army. • Commercial: Contractor performance is unsatisfactory and improvement is required in order to ensure critical milestone achievement. • Operations and Support: ARH System elements have commenced transition to In-Service Managers. | |||||||||
| ||||||||||
