Item | Original Planned | Achieved /Forecast | Variance (Months) | Variance Explanation / Implications |
Initial Materiel Release (IMR) | N/A | Aug 07 | N/A |
|
Aug 07 | Sep 07 | 1 | Variance is minimal at approximately 10 days Nil operational impact. | |
Final Materiel Release (FMR) ■ Heavy Airlift Capability | Dec 11 | Dec 11 | 0 |
|
Final Operational Capability (FOC) ■ Heavy Airlift Capability | Dec 11 | Dec 11 | 0 | All DMO inputs to FOC achieved by January 2011. Air force is yet to declare FOC and have until December 2011 in accordance with the Materiel Acquisition Agreement (MAA). |

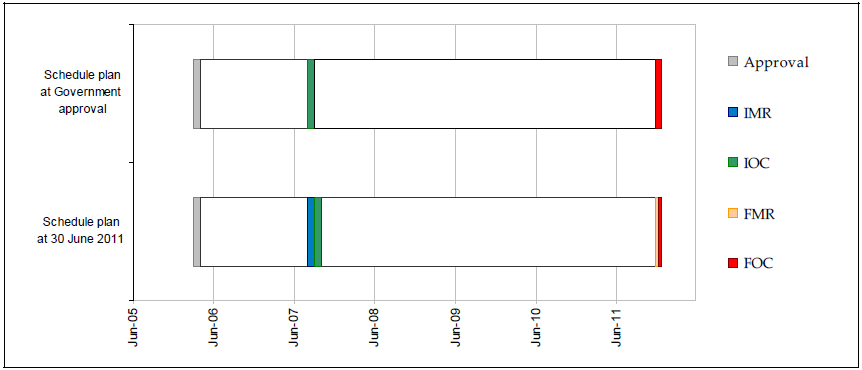

Schedule Status as at 30 Jun 11
