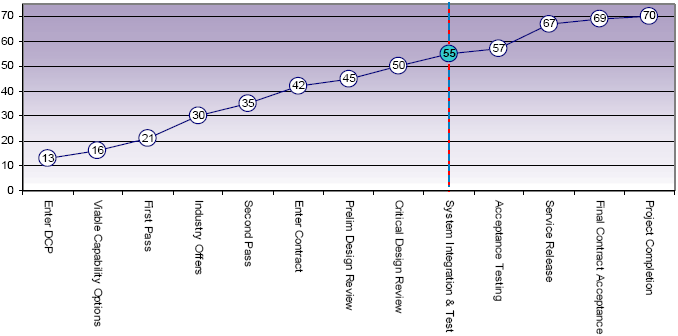

Maturity Score | Attributes | Total | |||||||
Schedule | Cost | Requirement | Technical Understand | Technical Difficulty | Commercial | Operations and Support | |||
Project Stage | Benchmark | 8 | 7 | 8 | 8 | 8 | 8 | 8 | 55 |
System Integration and Test | Project Status | 6 | 9 | 10 | 8 | 8 | 8 | 6 | 55 |
Explanation | • Schedule: The difference is a result of delays specifically associated with the Certification and subsequent FOC for Interim Anchoring Capability - now scheduled for Q4 2011. • Cost: The main cost component of the project, the WGS 6 satellite, is more than half complete and is forecast to be produced under budget. • Requirement: Three satellites are in orbit and all are being used operationally providing a known understanding of the capability to be provided by the constellation. • Operations and Support: Interim Anchoring will enter service and provide operational capability later than expected. | ||||||||
| |||||||||
