Item | Original Planned | Achieved /Forecast | Variance (Months) | Variance Explanation / Implications |
Initial Materiel Release (IMR) | N/A | Nov 04 | N/A |
|
Initial Operational Capability (IOC) - Core System | Nov 01 | Nov 04 | 36 | Delays due to Contractor delays with software development and system instability. Core System supported operations until IOC of Final System. No formal Operational Release, leading to FOC, was conducted on the Core System. |
IOC - Final System | May 04 | Oct 09 | 65 | Contractor delays with software development and system instability. Deferral of operational capability. |
Final Materiel Release (FMR) | Feb 16 | Feb 16 |
| The FMR date is based on the Mobiles program requiring 54 months to complete from Government approval of the scope change. |
May 05 | Jul 16 | 134 | Delays in IOC lead to consequent delays in FOC. FOC date now allows for completion of activities required post FMR (now that FMR date has been identified). Delays in gaining scope change approval and availability of skilled project office personnel may impact FOC schedule. This date is based upon the last of the 79 Mobiles upgrades obtaining FOC. Deferral of operational capability. |

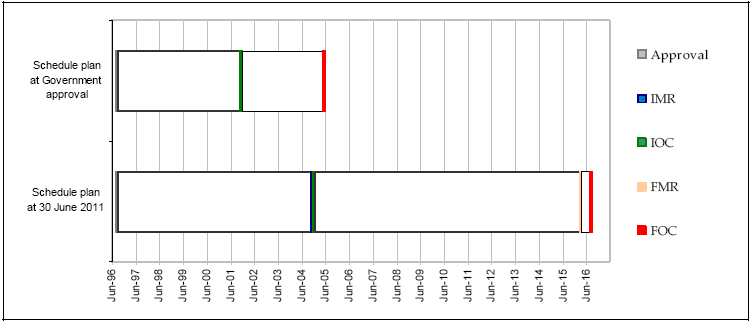

Schedule Status as at 30 Jun 11
