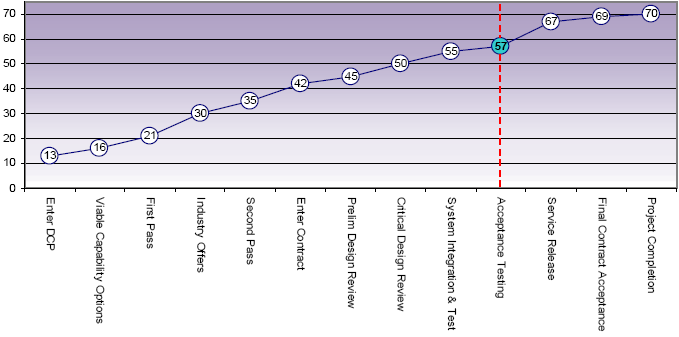

6.1  Project Maturity Score and Benchmark

Maturity Score

Attributes

Total

Schedule

Cost

Requirement

Technical Understand

Technical Difficulty

Commercial

Operations and Support

Project Stage

Benchmark

8

8

8

8

9

8

8

57

Acceptance Testing

Project Status

8

9

9

7

9

8

7

57

Explanation

•  Cost: Contingency (97% of the total provision available to the project) remains. A Real Cost Decrease via the Approved Major Capital Investment Program 2011-12 Portfolio Budget Statements has been proposed.

•  Requirement: HMAS Sydney has successfully completed the Stage 2 Mid-Course Guidance lead-ship Acceptance Test live fire events (June 2011).

•  Technical Understanding: Knowledge needs to operate and support the solution understood. No major impediments to acquiring and transferring this knowledge to the RAN.

•  Operations and Support: The support systems have been defined and procurement of long-lead support elements progressed.

2010-11 DMO MPR Status - - - - -
