3.3 Progress Towards Materiel Release and Operational Capability Milestones

Item

Original Planned

Achieved /Forecast

Variance (Months)

Variance Explanation / Implications

Initial Materiel Release (IMR)

Nov 11

Nov 11

0

Initial Operational Capability (IOC)

Dec 11

Dec 11

0

Final Materiel Release (FMR)

Aug/Sep 13

Aug/Sep 13

0

Final Operational Capability (FOC)

Dec 13

Dec 13

0

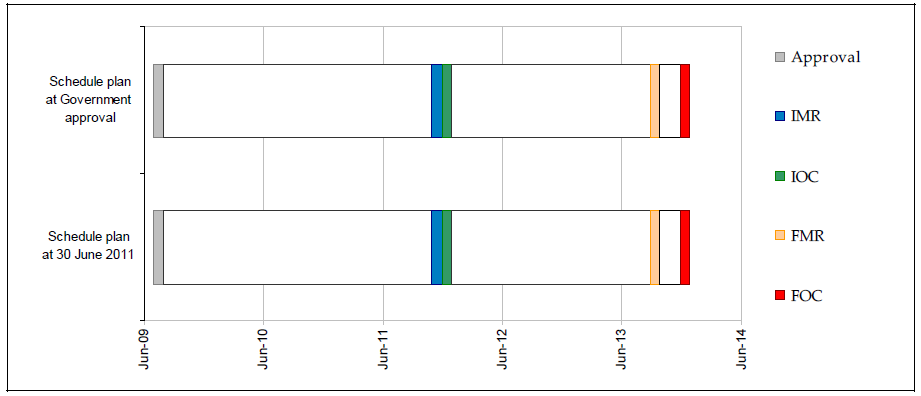

Schedule Status as at 30 Jun 11
