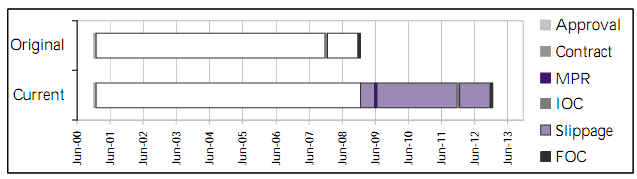

Schedule Performance - Project Approval to Capability Realisation

The schedule forecast for IOC and FOC has slipped by 48 months from the original plan caused by delays to system delivery as a result of problems associated with sub-system integration, supplier hardware availability, radar and electronic support measures maturity, and aircraft modification.
