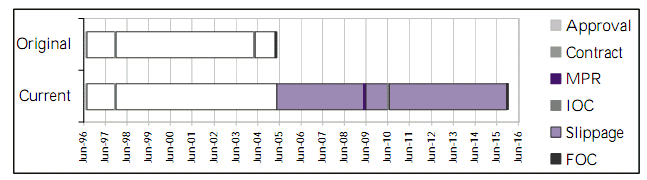

Schedule Performance - Project Approval to Capability Realisation

The schedule forecast for FOC on the final system (Fixed Network) has slipped by 74 months from the original plan caused by contractor delays with software development, resource shortages and system instability. The total slippage of 127 months shown in the graph above is based upon the last of the 87 Mobiles upgrades achieving FOC.
