Maturity Score | Attributes |
| |||||||
Schedule | Cost | Requirement | Technical Understanding | Technical Difficulty | Commercial | Operations and Support | Total | ||
Project Stage: Acceptance Into Service | Benchmark | 9 | 10 | 10 | 10 | 10 | 9 | 9 | 67 |
Current Project | 10 | 9 | 10 | 10 | 10 | 9 | 9 | 67 | |
Explanation | • Schedule: Project activities have been achieved on schedule. Remaining MAA activities are progressing on or ahead of schedule. • Cost: Year-end variance is primarily associated with the procurement of C-17 aircraft products being reprogrammed to comply with US Government FMS case mandatory requirements. | ||||||||
|
Project Stage: |
Total Benchmark Score |
Total Current Score |
|
|

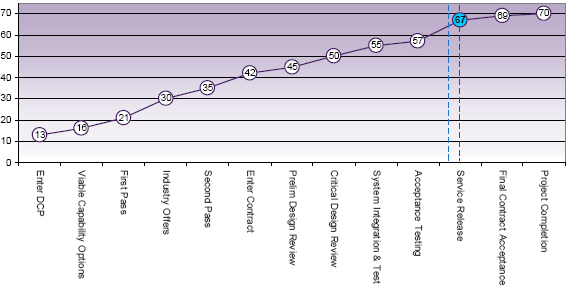

Acceptance into Service |
67 |
67 |
|
|
|
|||
