3.2 Construct Only (Lump Sum or Fixed Price)

This is a commonly used form of contract. The government has full responsibility for the design and documentation and engages a design team to develop the design documentation that forms part of the tender for the works. 1 The works are for the construction component only.

The following figure illustrates the contractual relationship of the principal with the design team and the contractor in a construct-only model.

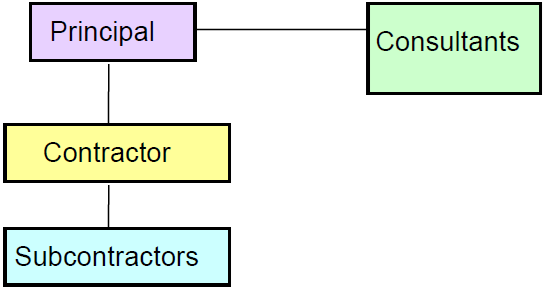

Figure 4: Construct-Only Structure

The contractor tenders a price for the works subject to adjustments provided for in the contract e.g. if there are variations. Irrespective of the actual cost of the works, the contractor will be entitled to be paid the contract sum, as agreed between the parties prior to commencing the works. However, in practice, the construct-only contract can exceed the original contract sum if not properly planned and managed.

Some examples of where construct-only contracts may be appropriate are:

the scope is well-defined and there is little likelihood of scope creep or wholesale changes to requirements;

there is little incentive or need for innovation from the contractor; and/or

it is desirable and there is sufficient time to complete design documentation prior to tendering.

The following table lists features of the construct-only model -

Advantages

Disadvantages (and issues that may need managing)

Highest level of departmental control and certainty re. scope because principal engages design consultants and scope is well defined prior to works commencing

Contract value is known before construction commences because:

- the full design is prepared and endorsed prior to tendering

- design complexities are resolved before contract award

Potential for lower cost of tendering for tenderers and departments (although design costs borne by departments)

Larger pool of potential tenderers, increasing competition

Greater scope for competitive prices because of design certainty

Government can manage stakeholder management process

Separate design and construction contracts mean no single point of responsibility for the project

Potential claims and delays due to design deficiencies and separation of design from construction

Minimal opportunity for cost value management or "buildability" input from contractor into design

The Government retains the risk of constructability of design, design-construction coordination, fitness for purpose and design generally

Inability to fast-track - long lead times to prepare design documentation - longer overall project duration

Little incentive for innovation

Government acts as project manager requiring skills and resources

Adversarial contract environment - potentially higher costs from claims

Potential lack of focus on lifecycle costs and considerations




__________________________________________________________________________________________________
1 Consultant engagement contracts for design services for major works may already be in place when the procurement strategy is being developed. With some of the delivery models, there is a design services contract separate from and/or preliminary to a construction works contract.
