Construction of the new laboratories has taken considerably longer than planned

1.10  Initially, construction proceeded as programmed, but, in summer 1999, JLC Ltd confirmed that it was experiencing problems with some of the mechanical and electrical systems in the first phase modules. It stated that completion of the phase would be delayed by a month, but the delay became progressive. As the build continued, problems emerged with construction of the other construction phases. The problems translated into delays to the completion of all of the phases, which for three phases amounted to nearly four years (Figure 5).

4

Laser's proposed redevelopment and reorganisation of the NPL site



The National Physical Laboratory Site at Teddington

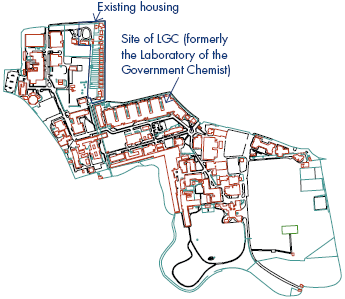

Before Development

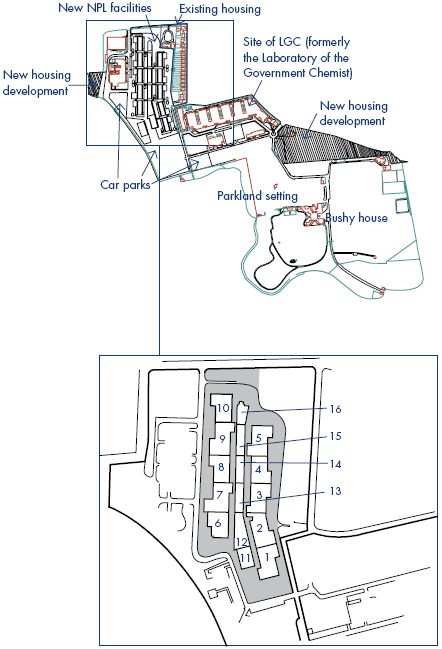

After Development

The contents of the new laboratory facilities

 Module

Contents



 1

Information systems; Electrical measurements; Environment



 2

Dimensional metrology; Information systems; Optical metrology; Electrical measurements; Time

 3

Dimensional metrology; Information systems; Metre and wavelength standards; Optical metrology; Electrical measurements; Optical radiation; Photonics

 4

Metre and wavelength standards; Basic metrology; Optical metrology; Electrical measurements; Time; Optical radiation; Photonics

 5

Basic metrology; Temperature; Thermophysics; Optical radiation

 6

Ionising radiation

 7

Materials; Force and mass; Humidity; Ionising radiation

 8

Materials; Pressure; Environment

 9

Materials

 10

Materials; Acoustics

 11

Goods in/out

 12

Engineering workshop; IT support

 13

Materials; Reprographics; Graphics; Conferencing

 14

Senior management; Finance; Marketing; Personnel; Health/safety and quality

 15

IT support; Restaurant; Library

 16

Meeting rooms; Security; Reception

 Source: National Audit Office and the Department



5

Laser planned to complete all 16 modules between October 1999 and March 2001 but it incurred delays which ranged from seven to 46 months











Construction
phase

Modules
included

Original target
completion date

Issue of completion
certificate

Delay
(months)

Phase 1

Modules 1, 2, 11 and 12

13 October 1999

29 June 20001

8.5

Phase 2

Module 13

21 October 1999

14 June 2000

7.8

Phase 3

Module 14

23 February 2000

07 September 2000

6.5

Phase 4

Module 3

26 February 2000

23 December 2003

45.9

Phase 5

Module 6

04 March 2000

26 April 2001

13.7

Phase 6

Module 7

04 May 2000

14 July 2003

38.3

Phase 7

Module 4

30 June 2000

08 April 2004

45.3

Phase 8

Module 15

06 July 2000

12 March 2001

8.2

Phase 9

Module 8

18 August 2000

06 October 2003

37.6

Phase 10

Module 16

05 October 2000

23 May 2001

7.6

Phase 11

Module 5

20 October 2000

05 July 2004

44.5

Phase 12

Module 10

02 March 2001

02 May 2003

26.0

Phase 13

Module 9

11 March 2001

12 February 2003

23.0

Phase 14

Car parks and gas bottle store

24 September 2001

Never issued2



Source: The Department







NOTES









1  Excluding four laboratories, the completion of which the Department agreed to transfer into Construction Phase 4.

2  The Independent Certifier issued construction completion certificates for three sub-phases of Phase 14, which covered various elements of the phase including the gas bottle store.

1.11  The problems causing the delays were many and various (Figure 6 overleaf). Two were particularly intractable:

  The design of the environmental control systems in 29 laboratories within Construction Phases 1, 4, 7 and 9 that were required to achieve the most stringent temperature control - Recognising that meeting these requirements would take a considerable time, the Department agreed to exclude these types of laboratories from Construction Phase 1 and incorporate them in Construction Phase 4. When the Independent Certifier issued his completion certificates for the three remaining phases, construction delays to the phases ranged between 38 and 46 months (Figure 5).

  The design of eight laboratories governed by stringent sub-audible noise requirements - In 2003, tests revealed that none of these laboratories met these requirements. Seven of the laboratories also had to comply with the most stringent temperature control requirements and, on investigation, Laser concluded that the air-conditioning needed to achieve the temperature control precluded attainment of the most stringent sub-audible noise requirements. After reviewing the issue, the Independent Certifier decided that the non-performance did not constitute a major defect preventing beneficial use of the modules. On this basis, he certified completion of the two affected construction phases: Phase 4 (Module 3) in December 2003; and Phase 7 (Module 4) in April 2004.

6

The Department identified numerous problems with JLC Ltd's design





Module/Area affected

Problem

Modules 1 & 2

The temperature and humidity controls were found to be inadequate.

Modules 2, 3, 4 & 8

Temperature control did not adhere to the most stringent requirements. Temperature control in line with the reduced control space agreed in the Technical Arrangement was eventually achieved after several years delay.

Modules 3 & 4

Stringent requirements governing control of sub-audible noise were not met.

Module 8

The Department considered that, in some of the laboratories, the gas extraction systems were unsafe.

Module 8

A pillar was put into a laboratory space in order to support plant in the roof space above. Contrary to the specification, the pillar was constructed of magnetic material that could potentially interfere with experiments sensitive to magnetic effects. Tests to date have not revealed interference problems although the pillar may become magnetised over time.

Module 9

Fume hoods designed to extract gases were found to be ineffective. Scientists were forced to move out of some module 9 laboratories until Laser fitted temporary corrective measures.

Module 12

The layout of the main workshop conflicted with the Department's interpretation of health and safety regulations.

Module 12

Difficulties were experienced in adhering to environmental control specifications in the main computer room.

Various Modules

There were strict dimensional specifications for access to the laboratories. JLC Ltd fitted large doors that were extremely heavy and impeded disabled access. As a result, it had to fit electronic door openers at extra expense. The Department maintains that there were alternative design solutions that could have avoided this extra cost.

Various Modules

Water dilution tanks were found to be ineffective.

Various Modules

The Department specified that residual current devices had to be fitted in the majority of laboratory spaces. These were not fitted. The devices are designed to prevent electric shocks and are considered best practice in industrial buildings. Laser fitted the required devices approximately two years after the first construction phase had been certified complete.

Various Modules

Humidifiers were installed incorrectly.

Site wide

Pipes used in the process cooling water system were susceptible to corrosion.



The environmental process cooling water system was not separated from the process cooling water system used to cool scientific equipment, therefore a system failure could result in scientific equipment becoming damaged.

Site wide

Marginal and, in some cases, inadequate capacity of machinery used to chill water for air-conditioning and process cooling water purposes.

Site wide

The electrical circuits servicing the site were arranged as a network of radial branches rather than a loop. Higher than designed electricity demand in a branch would result in electricity supply in the branch shutting down so threatening scientific work in the affected modules.

Source: The Department



1.12  The Department was not satisfied with the Independent Certifier's decision to issue completion certificates for the construction phases that included the eight laboratories that did not meet the most stringent sub-audible noise requirements. In October 2004, the Department referred the matter to adjudication. In December 2004, the adjudicator found in the Department's favour.

1.13  The adjudicator considered that the non-compliance did not constitute a defect as defined by the contract because the evidence before him had not demonstrated that the non-compliance could be directly attributed to a breach of contract by Laser. However, he considered that the non-compliance prevented beneficial use of the laboratories and decided that the Independent Certifier ought not to have issued his completion certificates. Consequently, the two construction phases affected were deemed not complete when the Department and Laser terminated their contract in December 2004.
