4.7  Project Management Office (optional)

A specialized company may be appointed to manage the project where needed. Financial and Economic Committee shall be responsible for assessing this matter and take the relevant decision, provided that the suggestion shall be included within the recommendations submitted to the Cabinet.

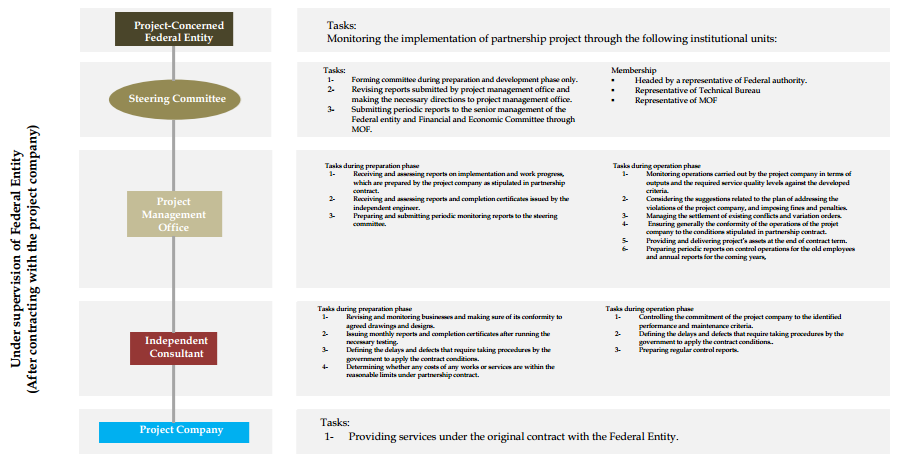

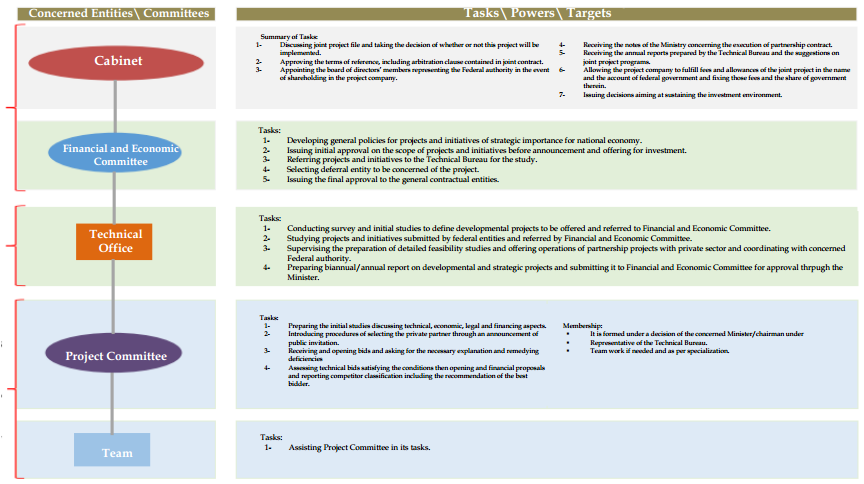

The below table summarizes the most important tasks and responsibilities of each stakeholder in partnership system in the Federal Government.

1- Preparation phase: this phase starts from the date of endorsing the PPP contract by the Cabinet until the completion of building, construction, development, reinstatement and rehabilitation, preparation and/or maintenance as stipulated in partnership contract.

2-  Operation phase: This phase starts from the date of commencing operations and service provision until the completion thereof as stipulated in partnership contract.
